Haller Wellfield South

Project Description

To meet growing water demands, the City is increasing raw water production capacity from its Haller Wellfield South located in Haller Park.   This project will install two additional production wells and upgrade the pump house and pumping equipment.  The City first looked for alternate water sources as part of its Water Source Expansion Project (follow link) before deciding to add two additional wells at the Haller South Wellfield.   In order to treat additional water being pumped from the Haller Wellfield South, the City is also engaged in a Water Treatment Expansion Project (follow link). These projects will ensure the Arlington community has a long-term source of clean drinking water for the future.

Project Benefits

  • Maintain excellent water quality
  • Expand drinking water production
  • Provide long-term sustainable water supply

Project Cost and Funding

  • Production Wells: $600,000
  • Pump house Improvements: $1,800,000
  • Funded by: City of Arlington Utilities

Project Schedule

  • Production well: 2023
  • Pump house Improvements: 2025-2026

Coordination with Local Residents

Regular schedule updates will be provided by the city to keep the community apprised of the progress on the project, and potential impacts.

Questions?

If you have questions or concerns about this project, please contact the city projects line at 360-403-3544 or cityprojects@arlingtonwa.gov

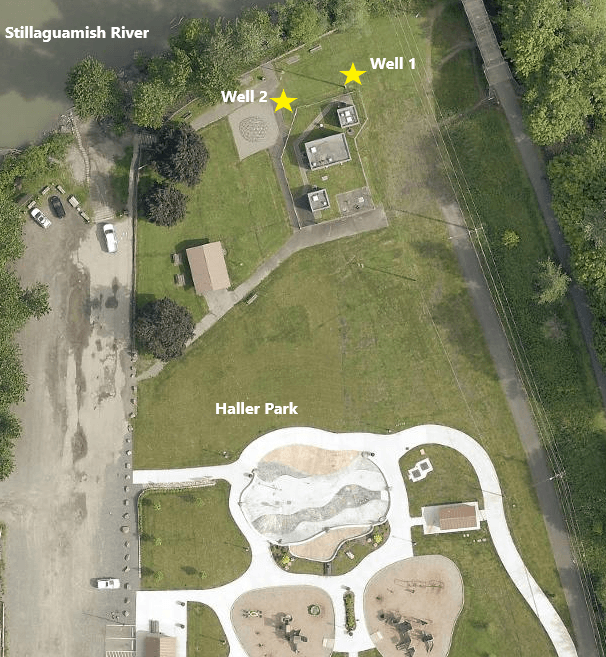

Haller Well South 2

Project Documents


To translate documents, download the document then click the link: https://translate.google.com/

Project Updates

  • August 8, 2023 - Project at 30% design, consultant is finalizing new pump house buildings and layout.  Getting ready for drilling new production wells in October.
  • October 13, 2023 - To meet growing water demands, the City is increasing its raw water production capacity from its Haller South Wellfield located at Haller Park. This project will install two additional production wells and upgrade the pump house and pumping equipment. The City first looked for alternate water sources as part of its Water Source Expansion Project before deciding to add two additional wells at this location. Construction began on October 12th with the demolition of the test wells. Drilling and testing of the two new wells is scheduled to begin on Tuesday, October 24th.   Construction on the wells and pump house is expected to be completed in late January to early February 2024.
  • October 27, 2023 - Drilling began on the first well at the Haller South Wellfield on Tuesday, October 24th. The contractor is expected to finish the drilling of the first well by the end of next week with screening and testing to follow.
  • November 3, 2023 - This week the drilling of the first well progressed as planned. Next week the contractor is expected to finish the drilling of the bore hole, with design, manufacturing, and installation of the well will follow. Construction on the two new wells is expected to be completed in late January to early February 2024.
  • November 9, 2023 - Next week’s work will include the completion of drilling for the first production well followed by the start of the well casing design.  After the well casing design is complete, activities will focus on the off-site manufacturer of the well casing followed by well casing installation and well pump testing.  Construction of the two new production wells is expected to be completed in late January to early February 2024.
  • February 23, 2024 - Construction of the new well at the Haller Wellfield is still ongoing. Please avoid the construction area when in the park.
